CAO YU THEATER ACOUSTIC DESIGN
LYN ACOUSTICS
Back to Showcase

CAO YU THEATER ACOUSTIC DESIGN

An acoustic design study for the 699-seat Cao Yu Theater at Beijing International Theater Center, balancing natural speech projection, intimacy, and measured reverberation control.

Location

BEIJING, CHINA

Venue Type

699-seat drama theater

Core Tech

Room form / ray tracing / ODEON

Target Metric

RT 1.10±0.10s / NR-25

Executive Snapshot:An acoustic design study for the 699-seat Cao Yu Theater at Beijing International Theater Center, balancing natural speech projection, intimacy, and measured reverberation control.

01. PROJECT INTRODUCTION. SECTION

Project Introduction

The Beijing International Theatre Center, located on the east side of the Capital Theatre on Wangfujing Street, is an expansion project for the Beijing People's Art Theatre. The project broke ground on December 27, 2018, and entered trial operation on September 2, 2021.

With a total construction area of approximately 23,000 m², it consists of four underground levels and three above-ground levels. The center houses one 699-seat medium-sized drama theatre, the Cao Yu Theatre, one 350-seat small theatre, the Renyi Small Theatre, and three rehearsal halls.

Exterior view of the Beijing International Theatre Center
FIGUREFigure 01. Exterior view of the Beijing International Theatre Center.
02. DESIGN TARGETS. SECTION

Function and Acoustic Design Targets

The Cao Yu Theatre is a dedicated venue for drama performances, also catering to small-scale variety shows. It offers superior viewing conditions and is designed primarily for natural sound performances.

Primary acoustic indicators include a mid-frequency full-occupancy reverberation time of 1.10±0.10s, background noise not exceeding the NR-25 noise evaluation curve, and no identifiable acoustic defects such as echoes, multiple echoes, sound focusing, or resonance at any position within the auditorium during performances.

03. ORIGINAL FORM. SECTION

Original Architectural Design and Ray Analysis

The Cao Yu Theatre is the core venue of the Beijing International Theatre Center. The original auditorium measured 22m in length and 24m in width, featuring only stall seating with no balconies, and had a maximum capacity of 699 seats.

While the completed version maintained the 699-seat capacity, row spacing was increased to enhance audience comfort. Since the ceiling shape in the original section was schematic, detailed section sound ray analysis was deferred to the interior design stage. Plan-view analysis indicated that suboptimal proscenium shaping and speaker opening positions left most seats without early side-wall reflections.

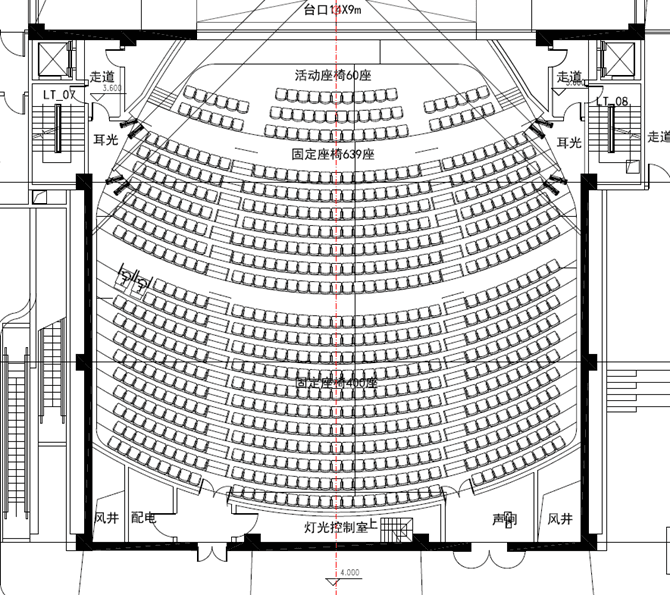

Original architectural plan of the auditorium
FIGUREFigure 02. Original architectural plan of the auditorium.

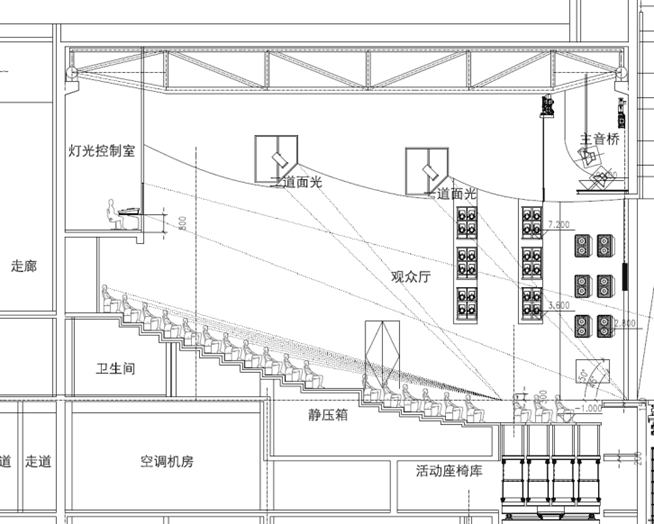

Original architectural section of the auditorium
FIGUREFigure 03. Original architectural section of the auditorium.
Sound ray analysis of the original architectural plan
FIGUREFigure 04. Sound ray analysis of the original architectural plan.
04. FORM OPTIONS. SECTION

Shape Improvement Schemes 1 and 2

The acoustic team proposed four volumetric improvement schemes. Schemes 1 and 2 required minimal civil engineering changes by adjusting the proscenium side wall shapes, with speakers configured in either surface-mounted or concealed formats.

In Scheme 1, the proscenium side walls were made slightly convex to ensure sound ray coverage for the front and middle sections of the stalls. Side wall openings for concealed speakers were also eliminated to prevent absorption of early sound energy.

In Scheme 2, concealed speaker openings were adjusted to positions that do not interfere with sound reflection, parallel to incident sound rays.

Improved plan for Scheme 1

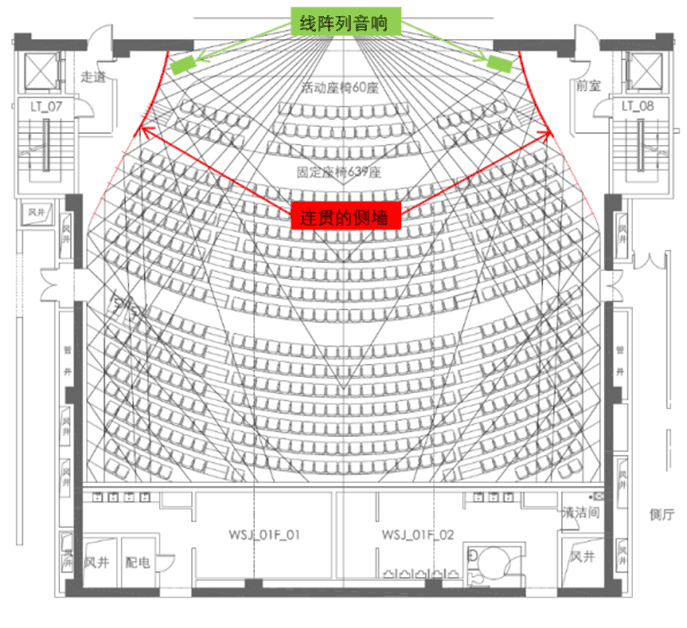

FIGUREFigure 05. Improved plan for Scheme 1.

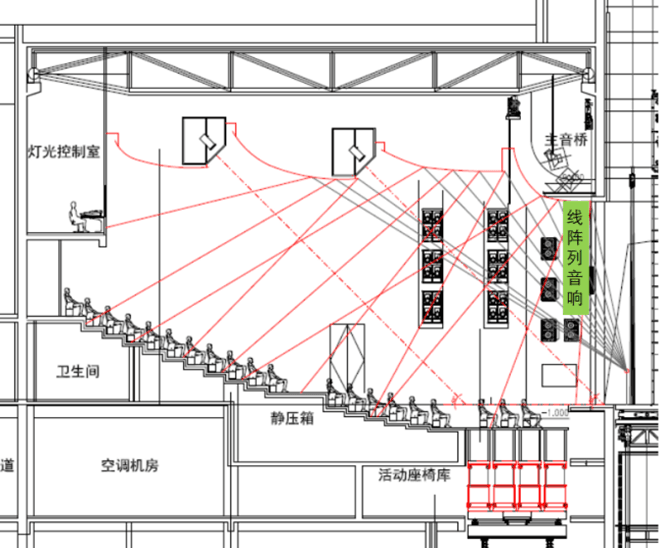

Improved section for Scheme 1
FIGUREFigure 06. Improved section for Scheme 1.

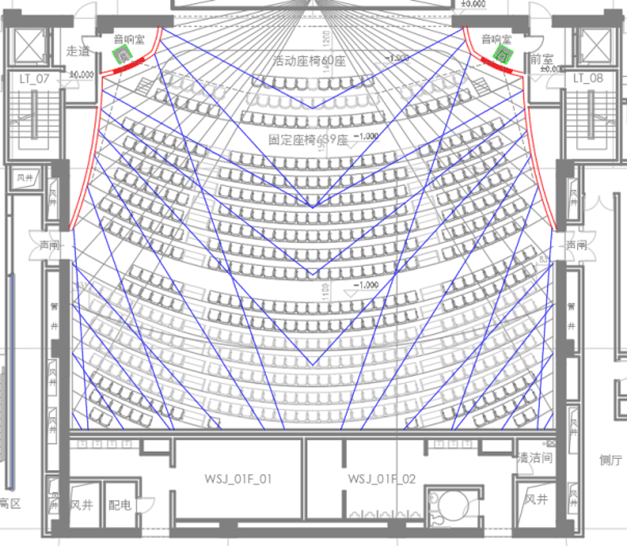

Improved plan for Scheme 2
FIGUREFigure 07. Improved plan for Scheme 2.
Improved section for Scheme 2

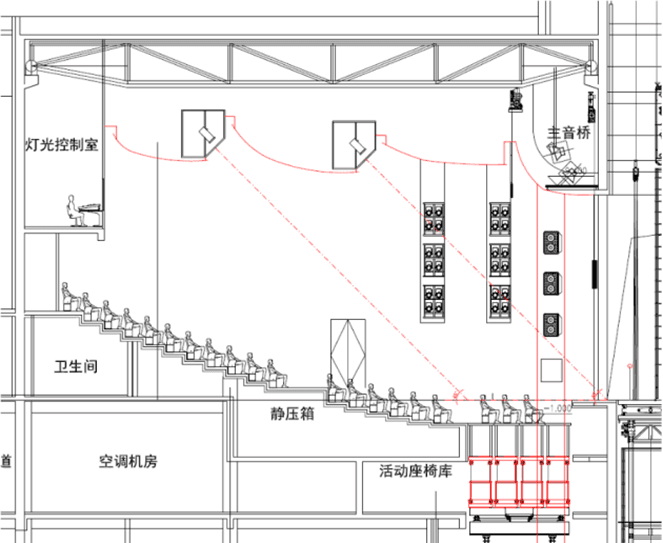

FIGUREFigure 08. Improved section for Scheme 2.
05. SIDE SEATING. SECTION

Scheme 3: Raised Side Seating

Schemes 3 and 4 were more comprehensive and better aligned with acoustic requirements. By raising the side areas of the stalls, the width was reduced from 24m to 20m, improving intimacy by reducing the Initial Time Delay Gap.

Scheme 3-1 raised the stall sides horizontally. Scheme 3-2 used a stepped, bud-shaped box configuration, again narrowing the room width to 20m while strengthening enclosure around the stage.

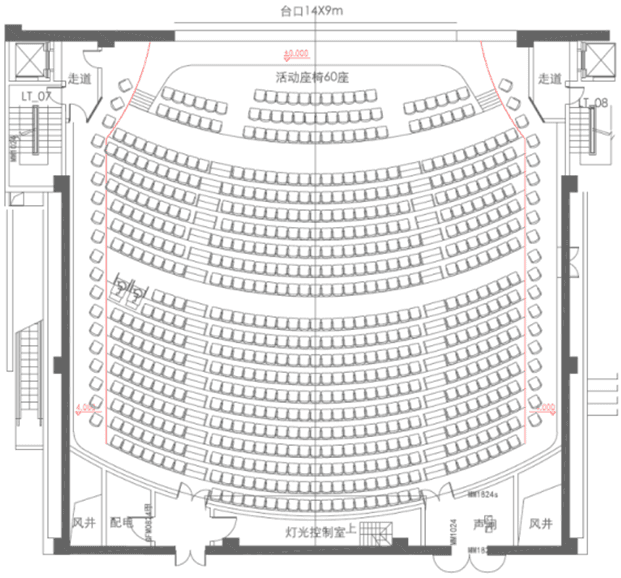

Improved plan for Scheme 3-1
FIGUREFigure 09. Improved plan for Scheme 3-1.
Improved section for Scheme 3-1

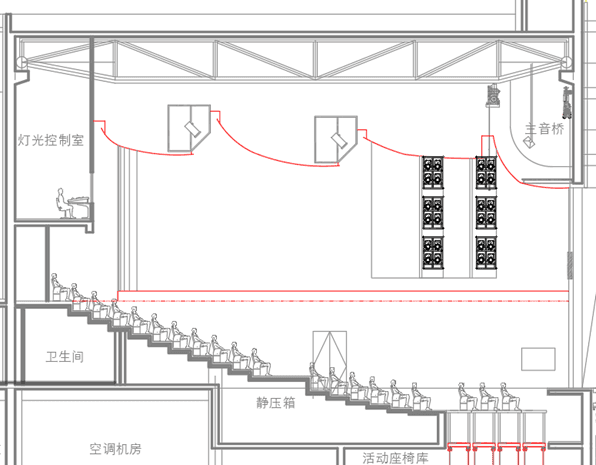

FIGUREFigure 10. Improved section for Scheme 3-1.
Improved plan for Scheme 3-2

FIGUREFigure 11. Improved plan for Scheme 3-2.

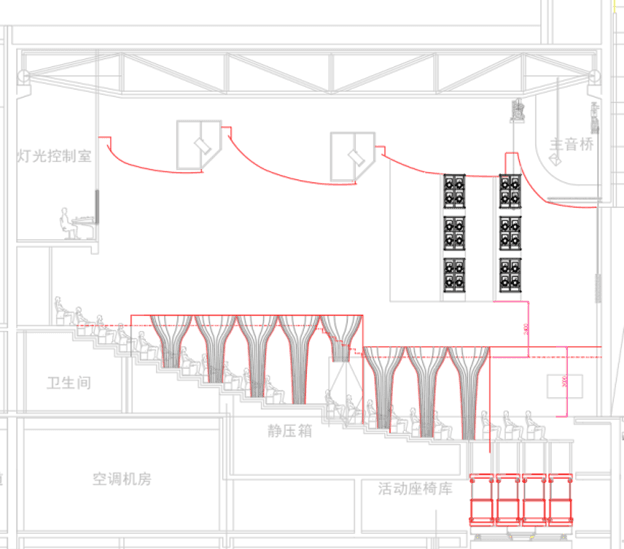

Improved section for Scheme 3-2
FIGUREFigure 12. Improved section for Scheme 3-2.
06. BALCONY OPTION. SECTION

Scheme 4: Added Balcony and Side Balconies

Scheme 4 raised the side seating and added a balcony level with side balconies. The side seating in the stalls and balconies was designed to embrace the stage, enhancing enclosure and strengthening the connection between actors and audience.

Scheme 4-1 raised the side seats horizontally and added a balcony level. Scheme 4-2 followed a similar strategy but used stepped side boxes.

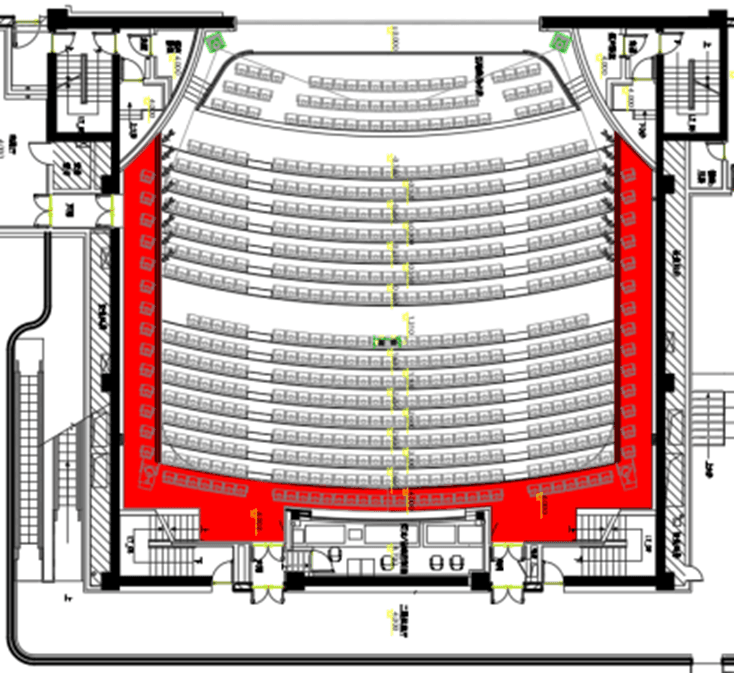

Improved 1F plan for Scheme 4-1
FIGUREFigure 13. Improved 1F plan for Scheme 4-1.

Improved 2F plan for Scheme 4-1
FIGUREFigure 14. Improved 2F plan for Scheme 4-1.
Improved section for Scheme 4-1

FIGUREFigure 15. Improved section for Scheme 4-1.

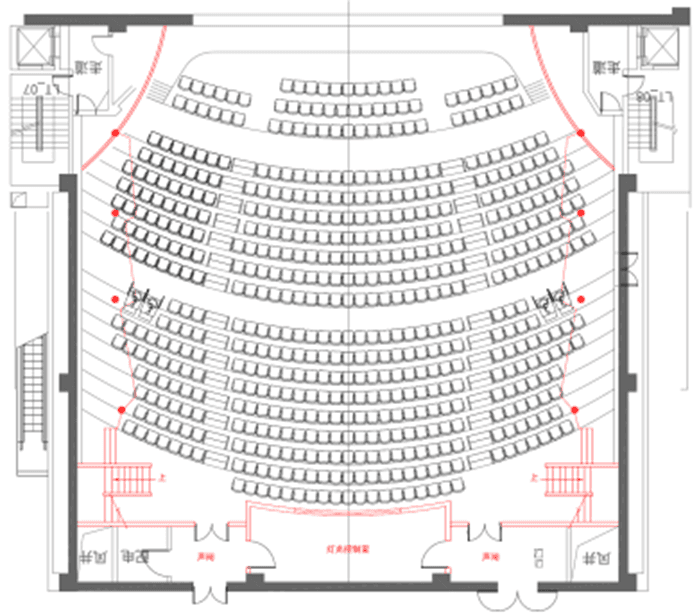

Improved 1F plan for Scheme 4-2
FIGUREFigure 16. Improved 1F plan for Scheme 4-2.
Improved 2F plan for Scheme 4-2

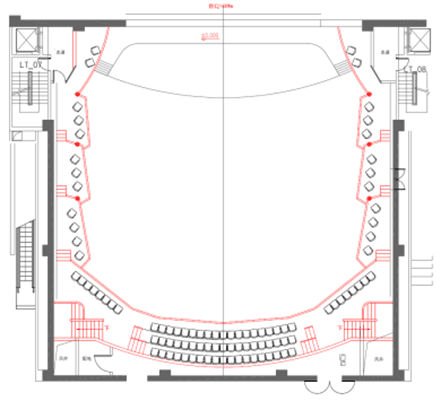

FIGUREFigure 17. Improved 2F plan for Scheme 4-2.
Improved section for Scheme 4-2

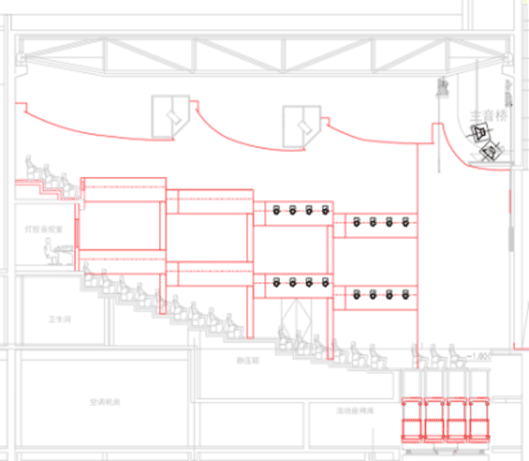

FIGUREFigure 18. Improved section for Scheme 4-2.
07. ADOPTED PLAN. SECTION

Adopted Scheme and Construction Drawings

The architectural team prioritized acoustic requirements from design through completion, and Scheme 4-1 was ultimately selected.

In the late construction drawing stage, requirements for concealed speakers and lighting were reintroduced. To mitigate the resulting sound absorption, the acoustic team fine-tuned the proscenium side wall shape so opening surfaces were as perpendicular as possible to the speaker axes, minimizing opening area.

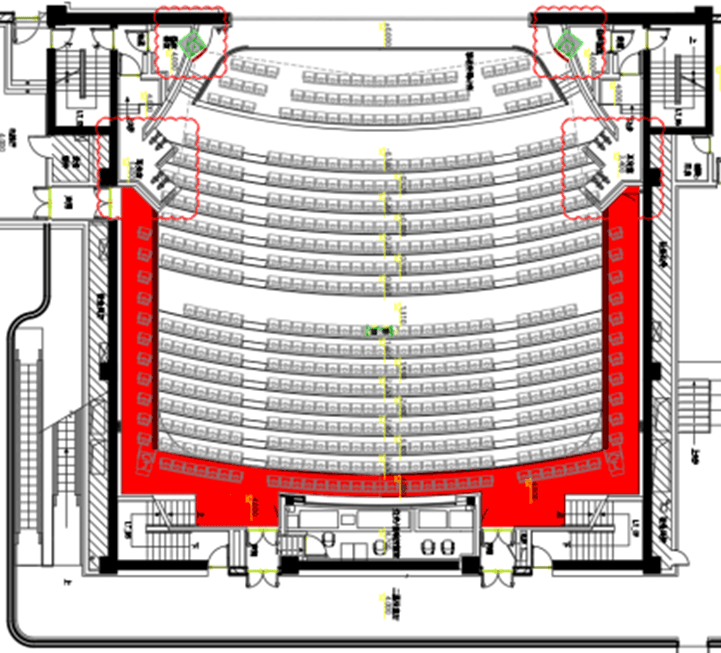

1F construction floor plan
FIGUREFigure 19. 1F construction floor plan.

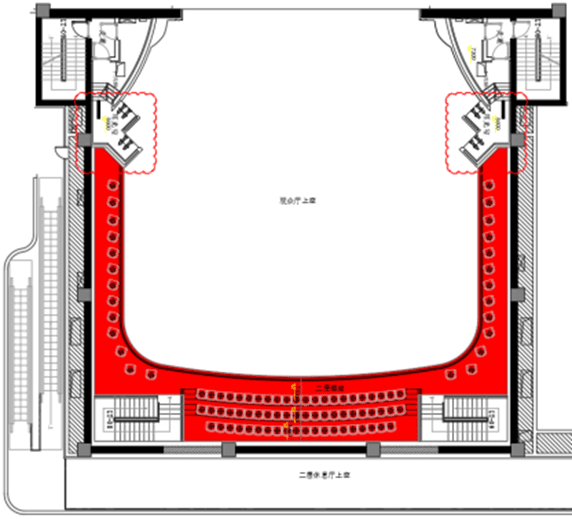

2F construction floor plan for Scheme 4-1
FIGUREFigure 20. 2F construction floor plan for Scheme 4-1.

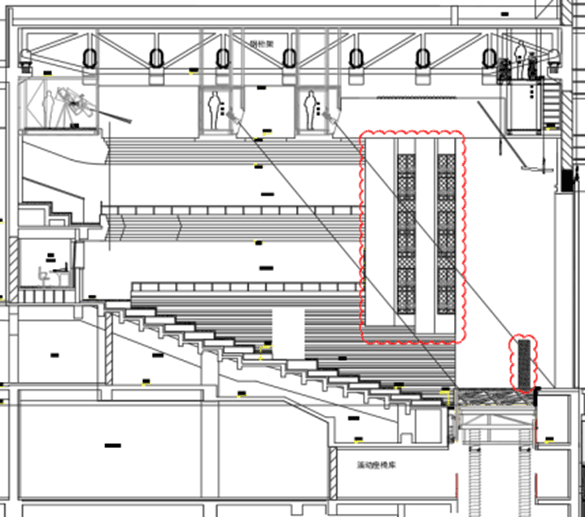

Construction section drawing for Scheme 4-1
FIGUREFigure 21. Construction section drawing for Scheme 4-1.
08. 3D RAY TRACING. SECTION

Interior Acoustic Intent and 3D Ray Analysis

The interior decoration incorporated elements of Beijing's Hutongs, using a staggered gray brick and wood style to highlight local cultural characteristics. The darker background also helps focus audience attention on the actors.

After the interior decoration scheme was initially defined, the acoustic team assessed the function of each reflective panel and ceiling surface. More than ten sound ray analyses were carried out as the decorative design evolved.

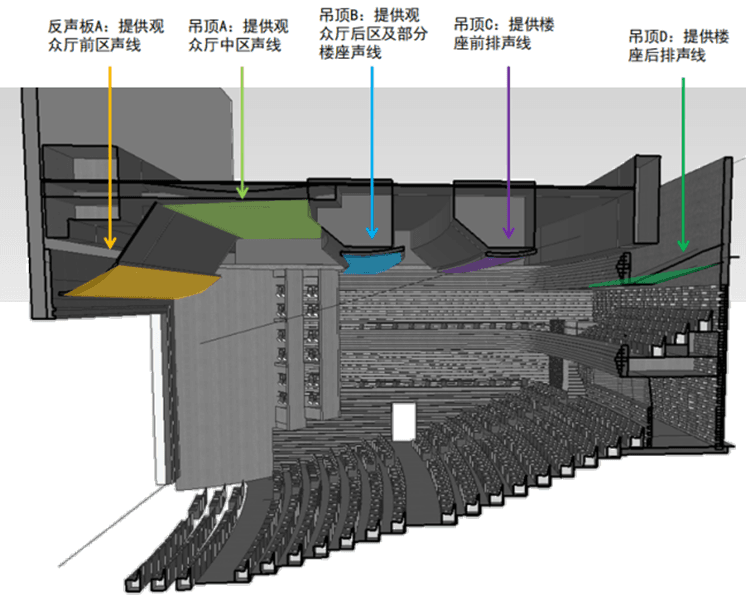

Acoustic requirements for the interior decoration scheme
FIGUREFigure 22. Acoustic requirements for the interior decoration scheme.
Sectional sound ray analysis of the interior decoration scheme

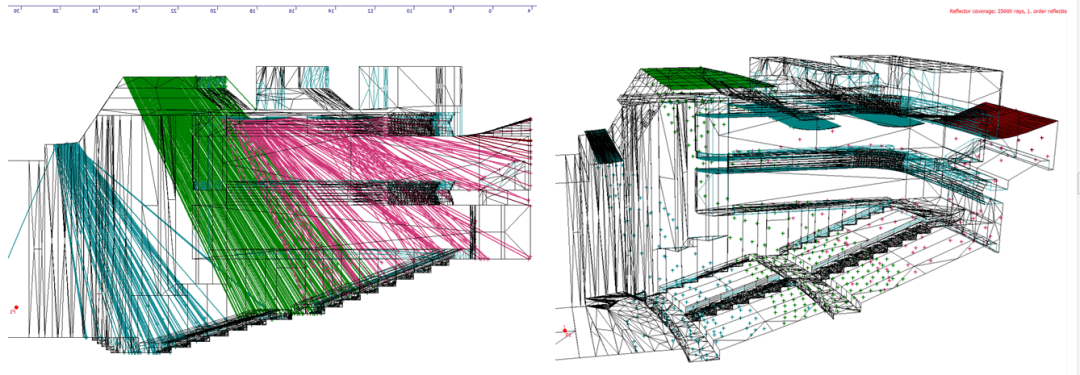

FIGUREFigure 23. Sectional sound ray analysis of the interior decoration scheme.
09. RAY REFINEMENT. SECTION

Ray-Path Refinement

As shown in the initial analysis, issues included a blind zone between reflective panel A and ceiling A, potential flutter echo between ceiling A and the stalls, excessive overlap between ceiling A and ceiling B, and ineffective zones for ceilings B and C.

The curvatures and angles of panel A and ceiling C were adjusted to resolve these issues and improve reflected sound coverage across the auditorium.

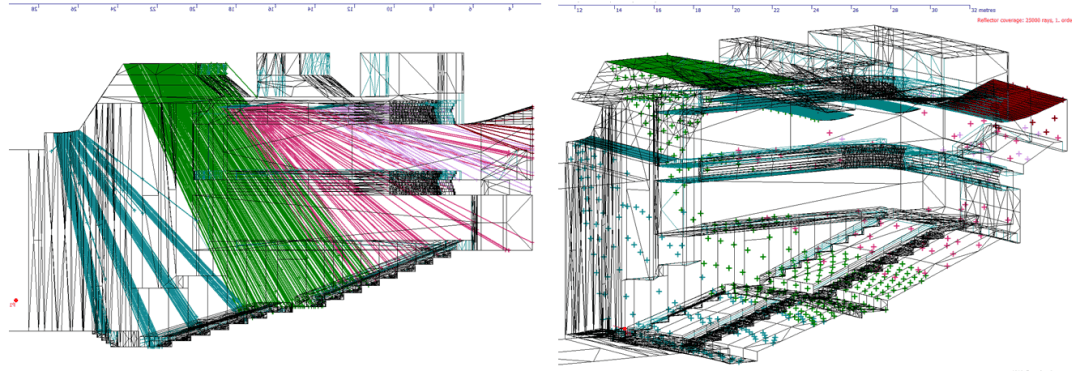

Sound ray analysis after sectional improvement of the decoration scheme
FIGUREFigure 24. Sound ray analysis after sectional improvement of the decoration scheme.
10. ODEON SIMULATION. SECTION

Computer Simulation and Absorption Layout

The original RT target was 1.2±0.10s under full-occupancy conditions, requiring no additional absorption and preserving sufficient loudness for natural sound. Later, the client requested a reverberation time matching the Capital Theatre, so the target was adjusted to 1.1±0.10s full occupancy.

To achieve this without altering volume, absorption was necessary. To minimize negative impacts on clarity and loudness, absorption was placed on surfaces reached only after first or multiple reflections, and the options were evaluated using ODEON grid and multi-point analysis.

Three schemes for the layout of absorbent materials in the auditorium
FIGURETable 1. Three schemes for the layout of absorbent materials in the auditorium.
11. T30 COMPARISON. SECTION

Reverberation Time T30 Comparison

Simulation showed that placing absorption on the rear balcony wall, Scheme 1, required the smallest area at approximately 80 m², while Schemes 2 and 3 required approximately 86 m².

For reverberation uniformity, both grid and multi-point calculations showed Scheme 3 to be the best, with approximately ±0.02s uniformity. Scheme 2 performed comparatively worse.

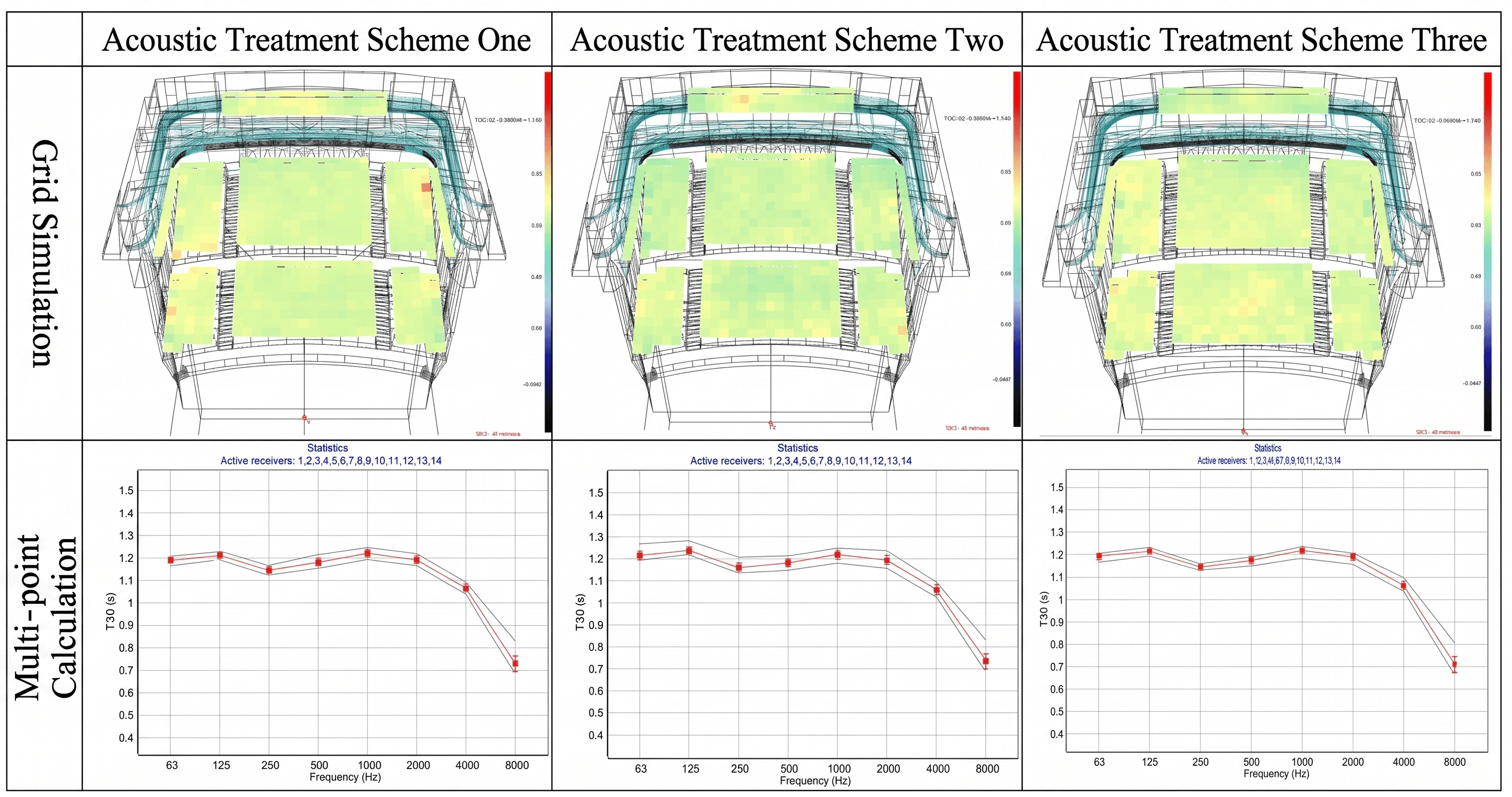

T30 grid simulation and multi-point analysis results
FIGURETable 2. T30 grid simulation and multi-point analysis results.

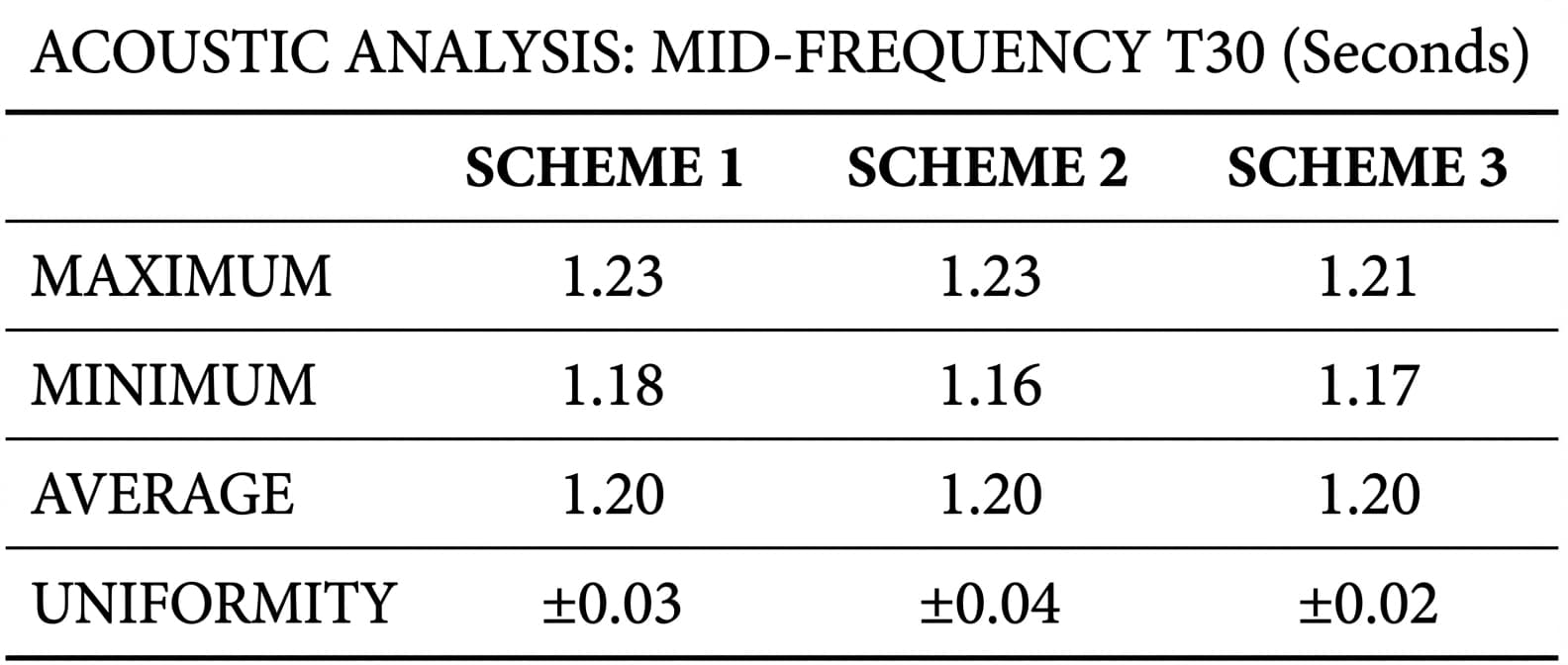

Summary of T30 parameters
FIGURETable 3. Summary of T30 parameters.
12. STRENGTH FACTOR. SECTION

Strength Factor G Comparison

As the absorption location changed, the distribution of Strength Factor G also shifted. Grid simulation showed that all three schemes had similar G-values in the stalls, while Scheme 1 produced significantly lower values in the balcony.

Multi-point calculations showed similar results. Schemes 2 and 3 improved the minimum G-values by more than 1dB compared with Scheme 1, and optimized G uniformity from ±3dB to ±2dB.

Strength Factor G grid simulation and multi-point analysis results

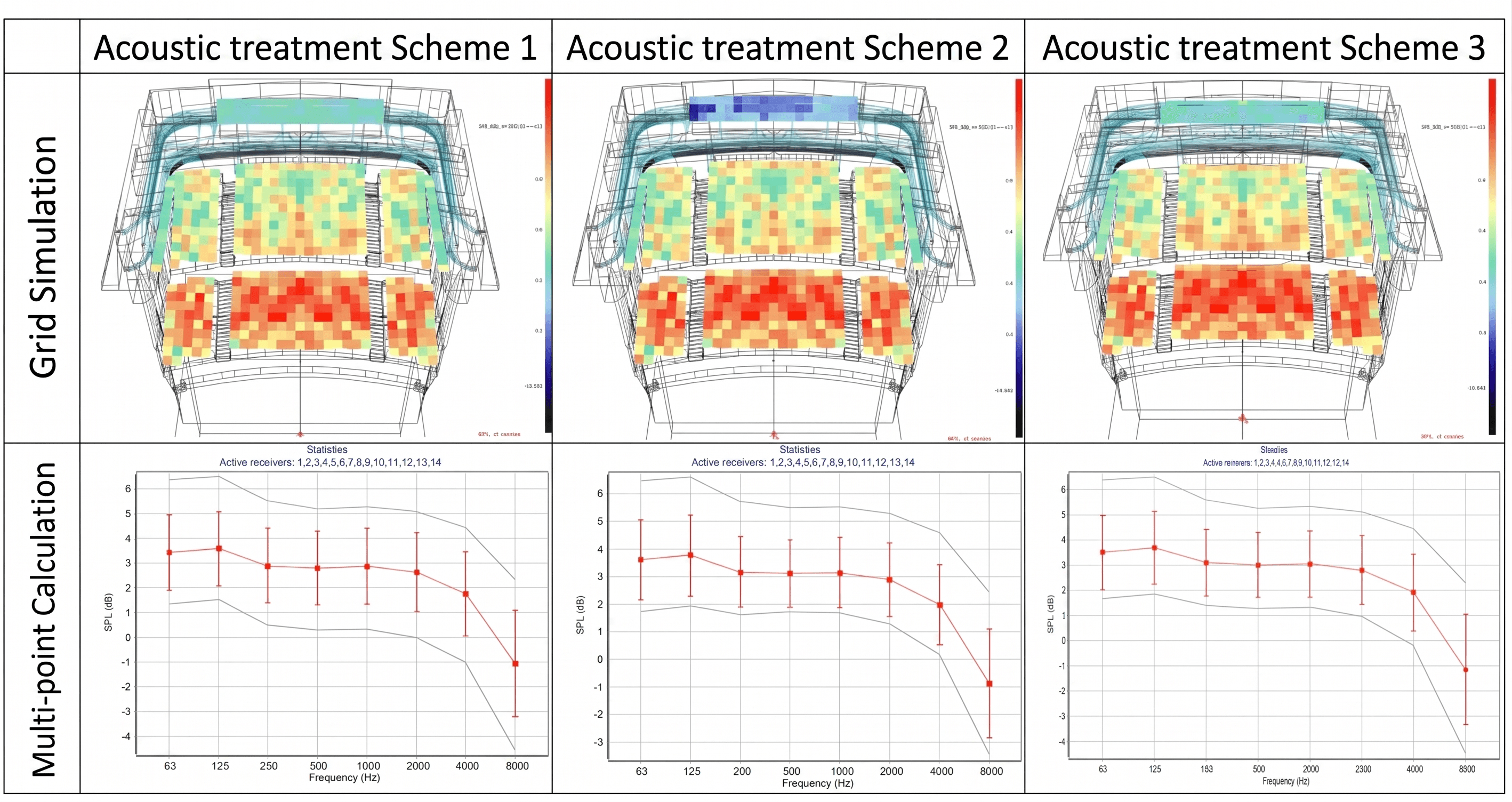

FIGURETable 4. Strength Factor G grid simulation and multi-point analysis results.
Summary of Strength Factor G parameters
FIGURETable 5. Summary of Strength Factor G parameters.
13. SPEECH CLARITY. SECTION

Definition D50 Comparison

The overall impact on Definition D50 was not significant across the three schemes, although some balcony and stall grid points showed slight differences.

The multi-point calculations were similar to the grid simulation. The D50 values of Schemes 1, 2, and 3 were largely consistent, while Scheme 2 provided the most uniform distribution.

Definition D50 grid simulation and multi-point analysis results

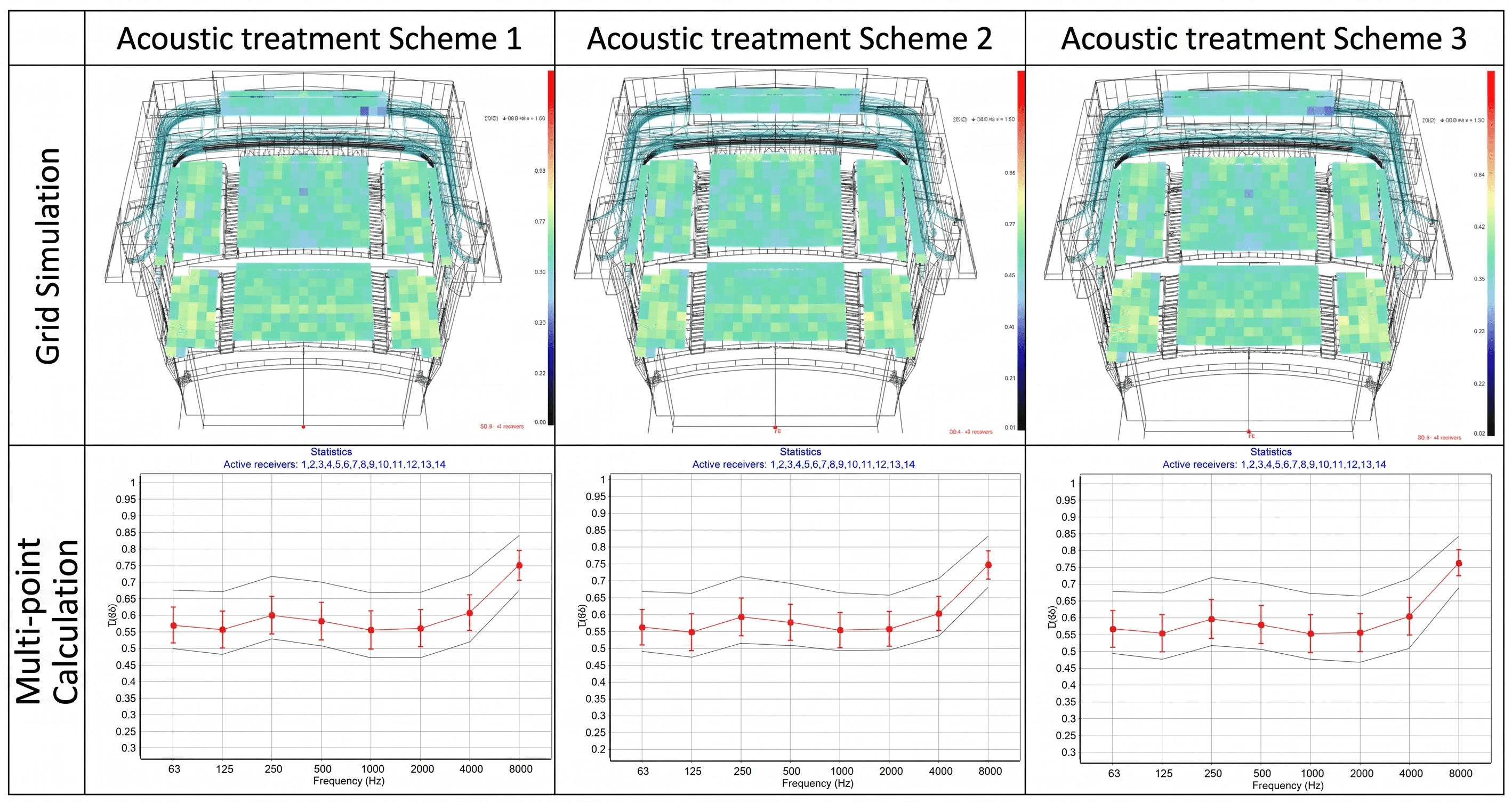

FIGURETable 6. Definition D50 grid simulation and multi-point analysis results.
Summary of Definition D50 parameters

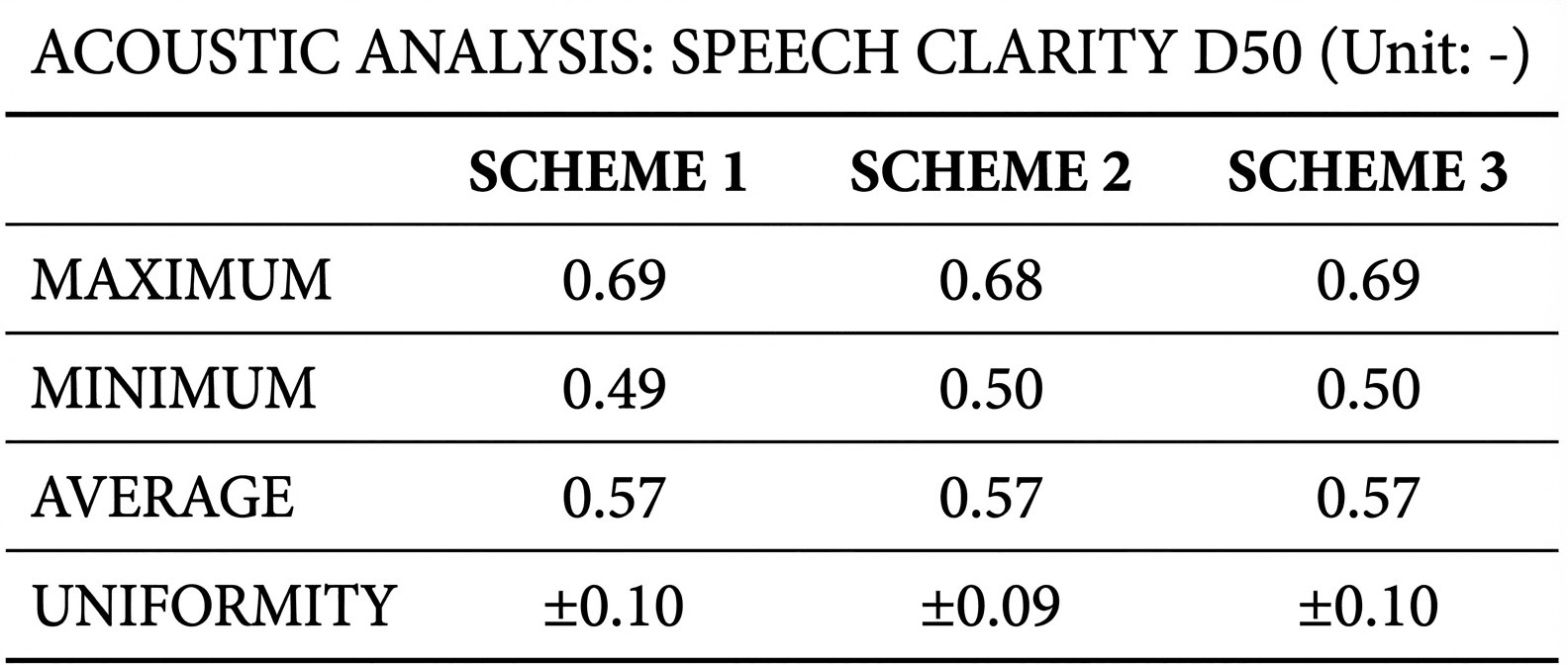

FIGURETable 7. Summary of Definition D50 parameters.
14. MEASURED RESULTS. SECTION

Measured Acoustic Results

Scheme 1 was excluded due to low G-values in the balcony. Between Schemes 2 and 3, Scheme 3 was ultimately selected for the absorbent layout to accommodate the installation of starry sky ceiling lights.

LYN ACOUSTICS conducted unoccupied acoustic testing at the Cao Yu Theatre on July 5, 2021, with stage curtains, scenery, and HVAC systems operational. Parameters were measured according to GB/T 36075.1-2018. T30 and D50 closely matched simulations, while G-values differed by 1.4dB, consistent with Beranek's research on calibration differences. Overall, the acoustic design fully met the requirements.

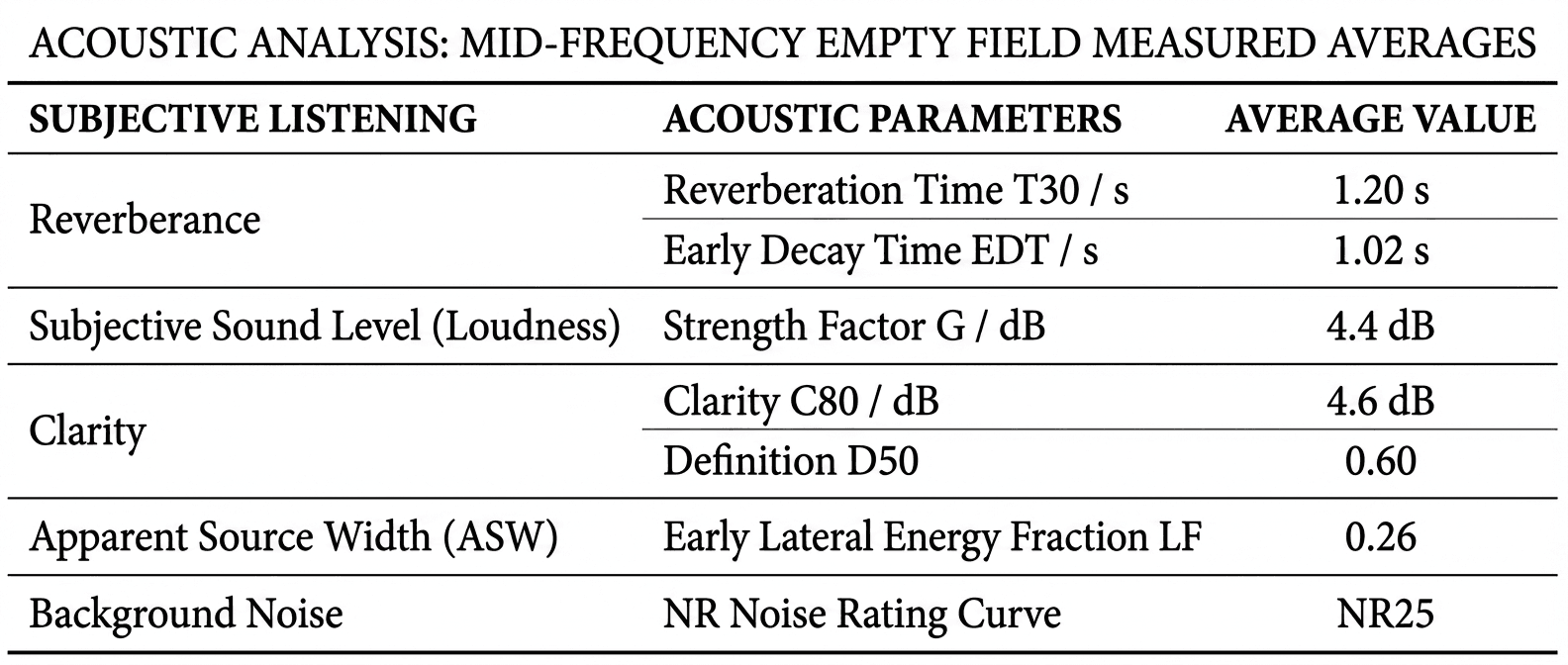

Measurement results of theatre acoustic parameters
FIGURETable 8. Measurement results of theatre acoustic parameters.
15. COMPLETION PHOTOS. SECTION

Completion Photos

Post-completion photographs show the final auditorium and balcony conditions, with the intimate room geometry and gray brick and wood interior language supporting the Cao Yu Theatre's drama-focused acoustic identity.

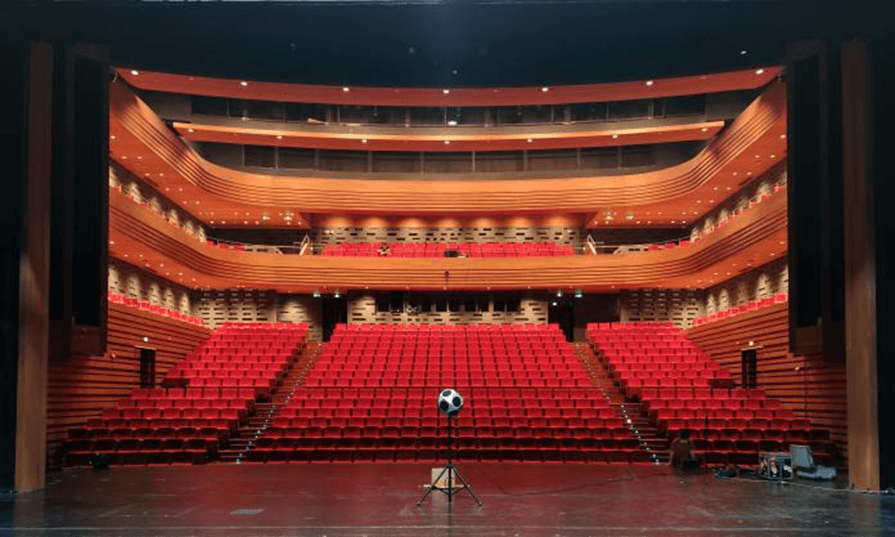

View of the auditorium from the stage
FIGUREFigure 25. View of the auditorium from the stage.
Side view of the auditorium
FIGUREFigure 26. Side view of the auditorium.

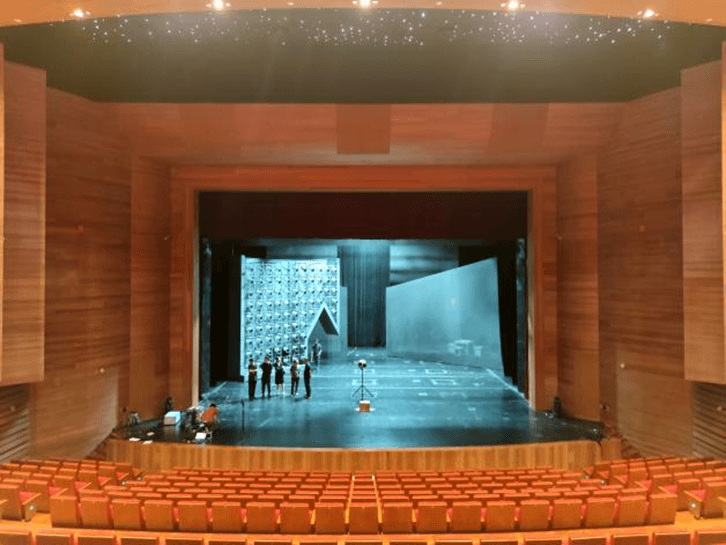

View of the stage from the auditorium
FIGUREFigure 27. View of the stage from the auditorium.

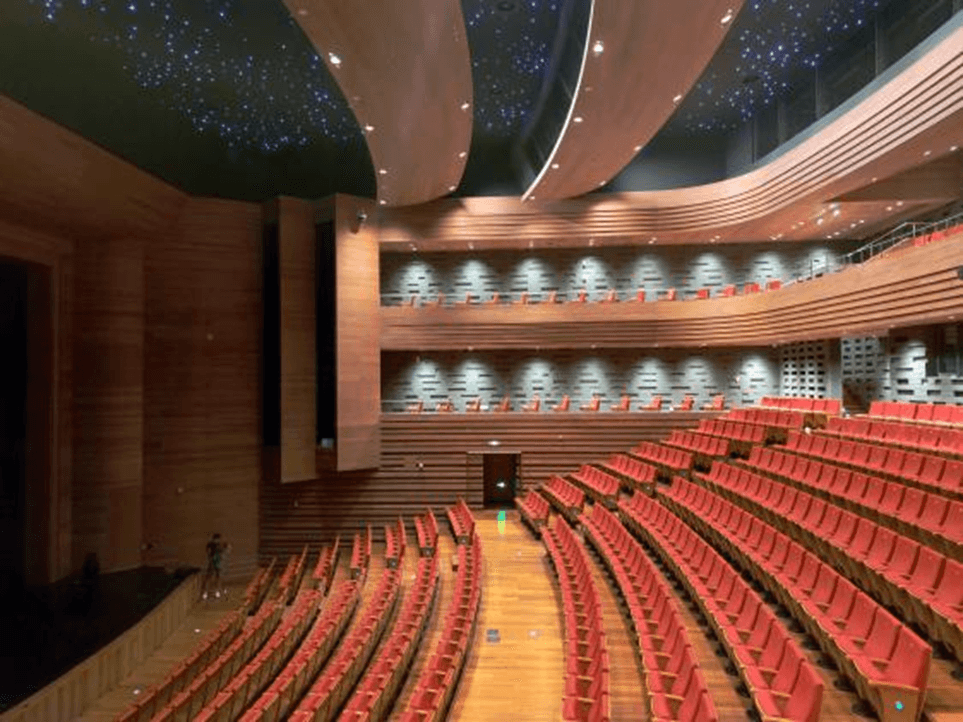

View of the balcony
FIGUREFigure 28. View of the balcony.
